Solar panel installations have to pass standard building regulations for the property - it’s a legal requirement for many home improvements.
The key areas are structural safety of a building (Part A) and electrical safety of a building (Part P). Your roof must be able to support the additional weight of rooftop panels and the electricals of the system must be safe. Standard health and safety practices must also be adhered to.
You do not need to make your own building regulations application if you use an installer which is a member of an approved Competent Persons Scheme (CPS). Your installer should be MCS certified and a member of a CPS for microgeneration technology, such as NICEIC. After commissioning of the system, you will receive certificates to prove it meets the required regulations.
In most cases, solar panels do not require planning permission as they fall under permitted developments. There are a few conditions that apply, depending on whether the property is domestic or commercial.
The installation of solar panels on a roof or wall of a private house is considered to be permitted development (i.e. doesn’t require planning permission) provided that:
_________________________________________________________________________________
For projects that require planning permission, we work in partnership with ET Planning, a specialist consultancy we trust.
At Spirit Energy, we produce all system designs and technical drawings to ensure everything is optimised from a solar and engineering perspective. ET Planning then manage the planning submission, liaise with the local authority, and handle any negotiations required to secure approval.
ET Planning are independent planning consultants supporting architects, landowners, developers, and businesses to reduce risk, make confident decisions and unlock value through the planning system across England and Wales. They provide comprehensive planning advice across all stages of the development process from initial site assessment through to securing permission and beyond.
This joined-up approach ensures your application is both technically robust and professionally managed from start to finish.
We also installed the solar system for Ben and Emily, the owners and directors of ET Planning, which reflects the strong working relationship and mutual trust between our teams.
_________________________________________________________________________________

Ground mounted installs will generally need planning permission unless the array is less than 9 square meters, but even then you should check. The portal implies that ‘standalone’ systems (by which we assume they mean ground mounted systems, but it is worth checking with your local authority that this is what they mean) don’t need permission as long as they comply with these very restrictive guidelines:

Regulations introduced in April 2015 deem most non-domestic solar installations below 1 MW as permitted development, provided:
Permitted development does not apply:
For systems greater than 50 kW: the Prior Approval of the Local Planning Authority is required, which is a much less prescriptive process than a planning application. This will assess the design and external appearance of the development, particularly in respect of the impact of glare on occupiers of neighbouring land.
There are three or four hurdles which may need to be overcome before an installation can proceed.
For domestic rooftop installations the only hurdle may be the structural report. In addition, if the system size exceeds 3.68kWp an application to the DNO is usually required if the house has a single phase supply (this limit is 3.68kWp per phase, so 11kWp on a 3 phase supply). Consent to connect to the grid is usually forthcoming for systems under 4kWp.
Allow 4-6 weeks between placing an order and completion of the installation.

Possible hurdles to be overcome will be as follows:

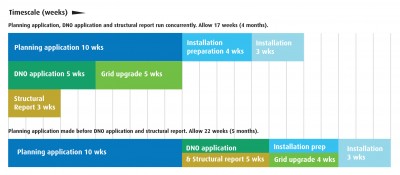

We will usually apply for planning permission, apply to the DNO and prepare a structural report concurrently, so that if all goes well, all of these hurdles can be overcome in 11 weeks. We are then free to proceed with the installation, which typically takes place four to six weeks after the planning decision. The installation itself will usually take between one and three weeks, depending on the size of the project, giving an overall project timeframe of around five months.
At the request of the client, and to reduce our costs (and theirs) in the event the planning application fails, we may delay applying to the DNO or preparing the structural report until the planning application is determined. This typically adds an additional two months to the proceedings, giving a complete timeframe of seven months.
A typical installation schedule for a large scale domestic or non-domestic installation would be as follows:

Once you have booked an installation, the process for domestic installs runs as follows:
As it says in the section on project timescales above, for domestic installations not requiring planning permission, you can expect to have your system up and running within about 4-6 weeks of contacting us, sooner if you are in a hurry.
